Factory tour

How a Topo Toppers camper is built

One build, followed from sheet metal to handover. Each stage below is what we watched happen, why it happens, and what is worth noticing.

Start with 5052 aluminum

What happens

Production begins with 5052 sheet aluminum. CAD parts are flattened and nested onto the loaded sheet, checked by the operator, cut by the fiber laser, and labeled for the next station.

Why this step exists

The material choice establishes the camper’s formed-and-welded construction. Laser cutting then creates the flat parts and pre-cut features that will be bent and joined.

What to notice

Thomas’s comparison with extrusion is Topo Toppers’ manufacturing rationale, not proof that this construction universally lasts longer. An operator still checks the cutting pattern before the automated program begins.

Source: Thomas from Topo Toppers · Manufacturer material rationale plus the Ventura cutting process shown during filming.

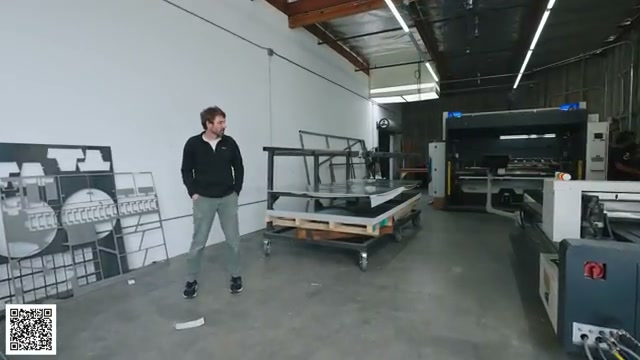

Thomas from Topo Toppers standing beside sheet aluminum near the laser-cutting station
The sheet aluminum at the beginning of the camper-building process.

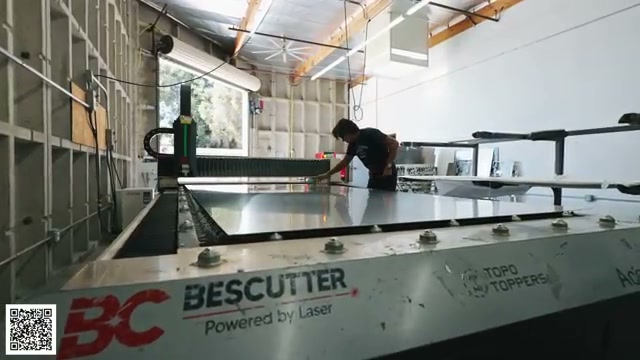

A sheet of aluminum positioned on the fiber-laser cutting table
A loaded sheet before the fiber laser cuts the nested parts.

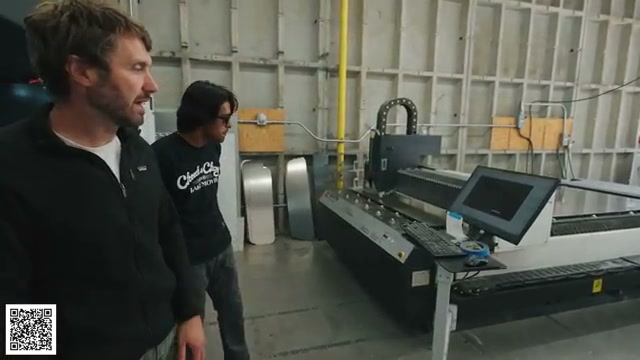

Thomas and a laser operator beside the fiber-laser control station
The cutting program is checked before the operator begins the run.

Deburr and form the parts

What happens

Fresh-cut parts are deburred, and the areas that will be welded are sanded before the pieces go to the press brake. The first bend is checked before the operator continues through the batch.

Why this step exists

Removing burrs and surface oxidation prepares the weld areas. Bending turns the flat pieces into doors, rails, panels, and other camper components.

What to notice

Not every bend carries the same consequence. Thomas gives the Rincon side-panel chamfer as a model-specific example where a small angle error can keep adjoining parts from lining up.

Source: Thomas from Topo Toppers · The Rincon example is model-specific, not a universal tolerance.

Thomas beside the work area where freshly cut aluminum parts are deburred
Fresh-cut parts move through the deburring area before forming.

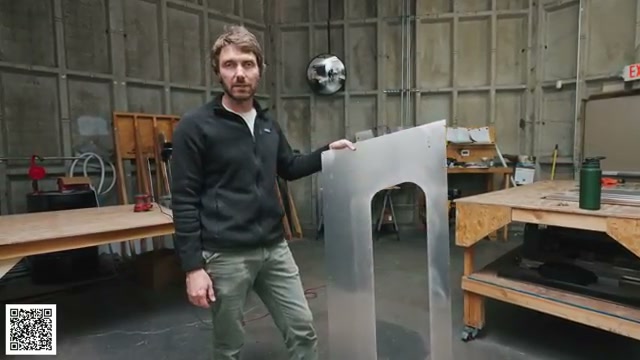

Thomas holding a formed aluminum camper part
A flat laser-cut part after press-brake forming.

An operator working at the press brake in the Topo Toppers factory
The press brake bends the prepared aluminum parts.

TIG-weld, grind, and inspect

What happens

Formed pieces are fitted, tacked, and clamped before being TIG-welded. The welder works around the part to manage heat-driven movement, after which the exterior welds are ground and polished.

Why this step exists

Welding joins the formed pieces into rails and body panels. Grinding brings the visible exterior flush before the camper reaches its fit check and final finish.

What to notice

The fixture does not replace operator judgment because aluminum moves as it heats. After the outside is polished, Thomas points to the bead left underneath as the practical weld-penetration check he uses.

Source: Thomas from Topo Toppers · Manufacturer process explanation, not an independent structural test.

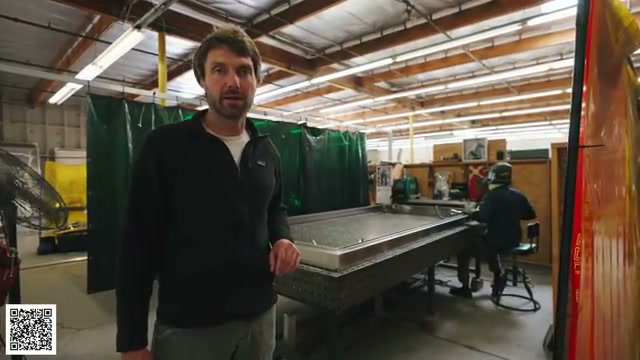

Thomas beside the aluminum welding and fixture area
The formed pieces arrive at the welding station.

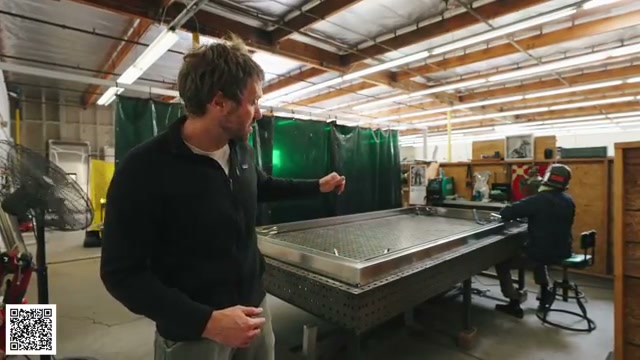

A worker and Thomas examining aluminum pieces held in a welding fixture
Formed pieces are fitted and held before the weld is completed.

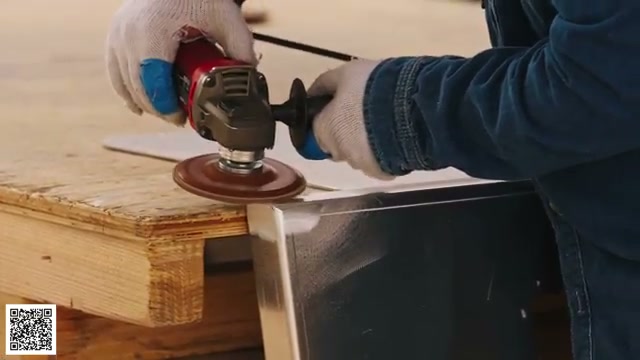

A close view of an aluminum exterior weld being ground and polished
The visible exterior weld is ground and polished after welding.

Test-fit before powder coating

What happens

Before powder coating, the raw-aluminum body and roof components are clamped together for a complete fit check. The bed pan is measured for that particular assembly, and the remaining interfaces are checked before the pieces leave for finishing.

Why this step exists

The mock-up catches alignment problems introduced across cutting, bending, and welding before a finished part becomes more expensive to remake.

What to notice

Accurate machines do not remove accumulated manufacturing variation. This is the deliberate human-verification point between fabrication and powder coating.

Source: Thomas from Topo Toppers · Point-in-time process description; no production tolerance records were reviewed.

Raw aluminum camper components clamped together in the factory
The uncoated camper components are assembled for a fit check.

A worker measuring the raw aluminum camper assembly
The assembly is measured before the parts leave for finishing.

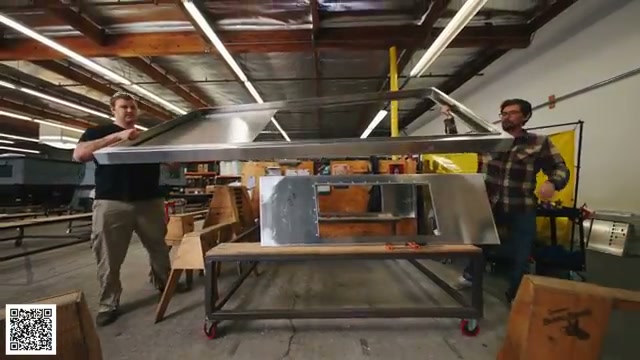

Two workers checking the fit of raw aluminum camper components
The team checks how adjoining components fit together.

Cut and sew the tent

What happens

A plotter cuts the tent fabric, clear window vinyl, mattress material, and roof vinyl from digital patterns. The tent components are then sewn and assembled in-house.

Why this step exists

These are the flexible parts that must fold with the camper while managing sun and weather exposure. Material choice, seam placement, overlaps, and construction all contribute.

What to notice

Thomas puts as much emphasis on construction and care as on the fabric itself. Seams are arranged to shed water, while keeping the tent clean, dry, tucked, and unpinched remains part of caring for it.

Source: Thomas from Topo Toppers · Material and care explanation, not an independent waterproofing or service-life test.

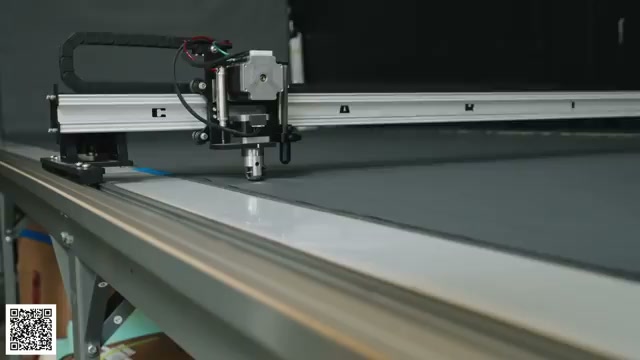

A plotter cutting flexible material from a digital pattern
The plotter cuts the flexible camper components from digital patterns.
A worker sewing flexible camper material at the Topo Toppers factory
Cut pieces are sewn and assembled in-house.

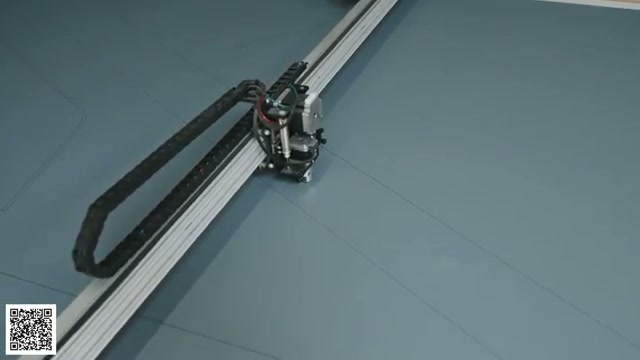

Flexible camper material moving through the cutting plotter
The same cutting system handles several flexible camper materials.

Assemble and seal the camper

What happens

After powder coating, the roof receives hardware, gaskets, and reflective vinyl, while the lower panels are taped and bolted together. The tent, roof, hinge panels, struts, doors, and perimeter sealant then turn those subassemblies into the camper shell.

Why this step exists

This is where finished components become one camper while the sealing interfaces remain accessible. Tape or foam between bolted interfaces and perimeter sealant perform different jobs.

What to notice

This stage contains the single rejected top rail Braxton observed. It shows one decision made during this build, not a defect rate, rejection rate, or guarantee about every camper.

Source: Thomas’s process account plus Braxton’s firsthand observation of one rejected rail.

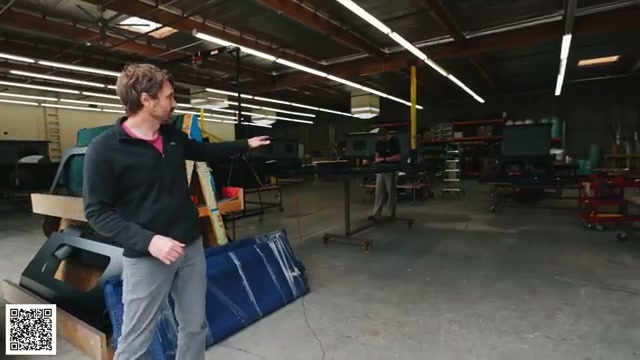

Thomas showing a roof component during camper assembly
Roof components receive hardware and finishing materials during assembly.

Finished camper components staged in the Topo Toppers assembly area
Finished components are staged before they are assembled into the camper.

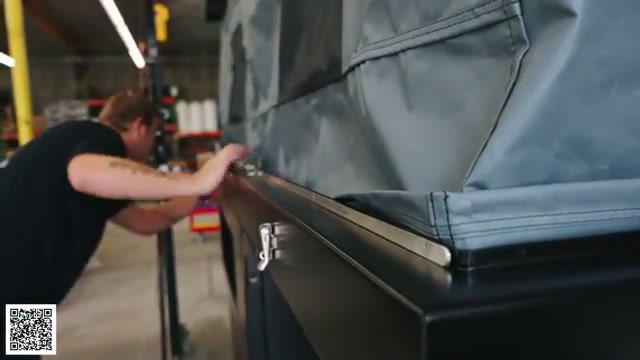

A worker assembling the tent and finished camper shell
The tent, roof, and lower body come together during final shell assembly.

Equip, inspect, and install

What happens

The ordered electrical and accessory equipment is installed, the front-access windows receive the additional sealing process shown during filming, and completed campers go through checklist-based final QC before shipment or truck installation.

Why this step exists

In the filmed sequence, final QC is the last documented checkpoint for integrated and supplied components before shipment or truck installation. Mounting then varies by the exact truck.

What to notice

The light configuration changed after filming, the window process applies to the front-access windows Thomas discussed, and mounting varies by truck. The closing service discussion is qualitative, not audited performance data.

Source: Thomas from Topo Toppers + the process shown during filming · Equipment, window, and mounting details are time- and fitment-specific.

A close view of electrical work inside a camper during final equipment installation
Ordered electrical equipment is installed before final inspection.

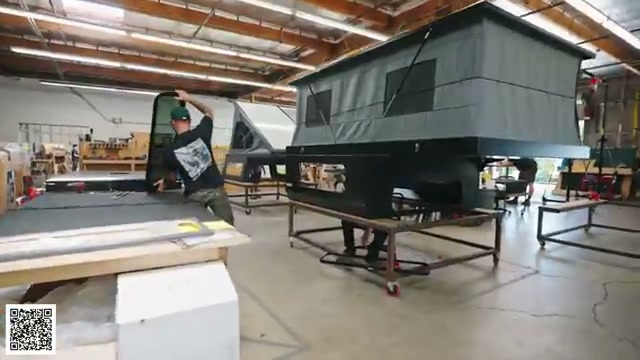

A completed Topo Toppers camper staged inside the factory
A completed camper waits in the factory before handoff or installation.

A worker checking a completed camper during the final stage
The completed camper receives its final checks before handoff.
